The Acute-Phase Problem Inside the Larger Crisis

In our previous article on Permian Basin produced water volumes, we saw daily basin-wide volumes exceed 10.5 million barrels — and still rising.

But inside that massive figure lies a sharper challenge: fracking flowback. This is not just more produced water. It has unique chemistry, extreme volume spikes, and urgent treatment needs. As multi-well pads become standard, flowback is exploding. This article traces how Permian operators have evolved treatment from old open pits to 2026’s optimized polymer systems.

Era 1: The Open Pit Era (Pre-2008)

In the late 1990s and early 2000s, flowback management was basic: dig an unlined earthen pit next to the well, route everything in, and let evaporation handle it. West Texas sun did the job — at nearly zero cost.

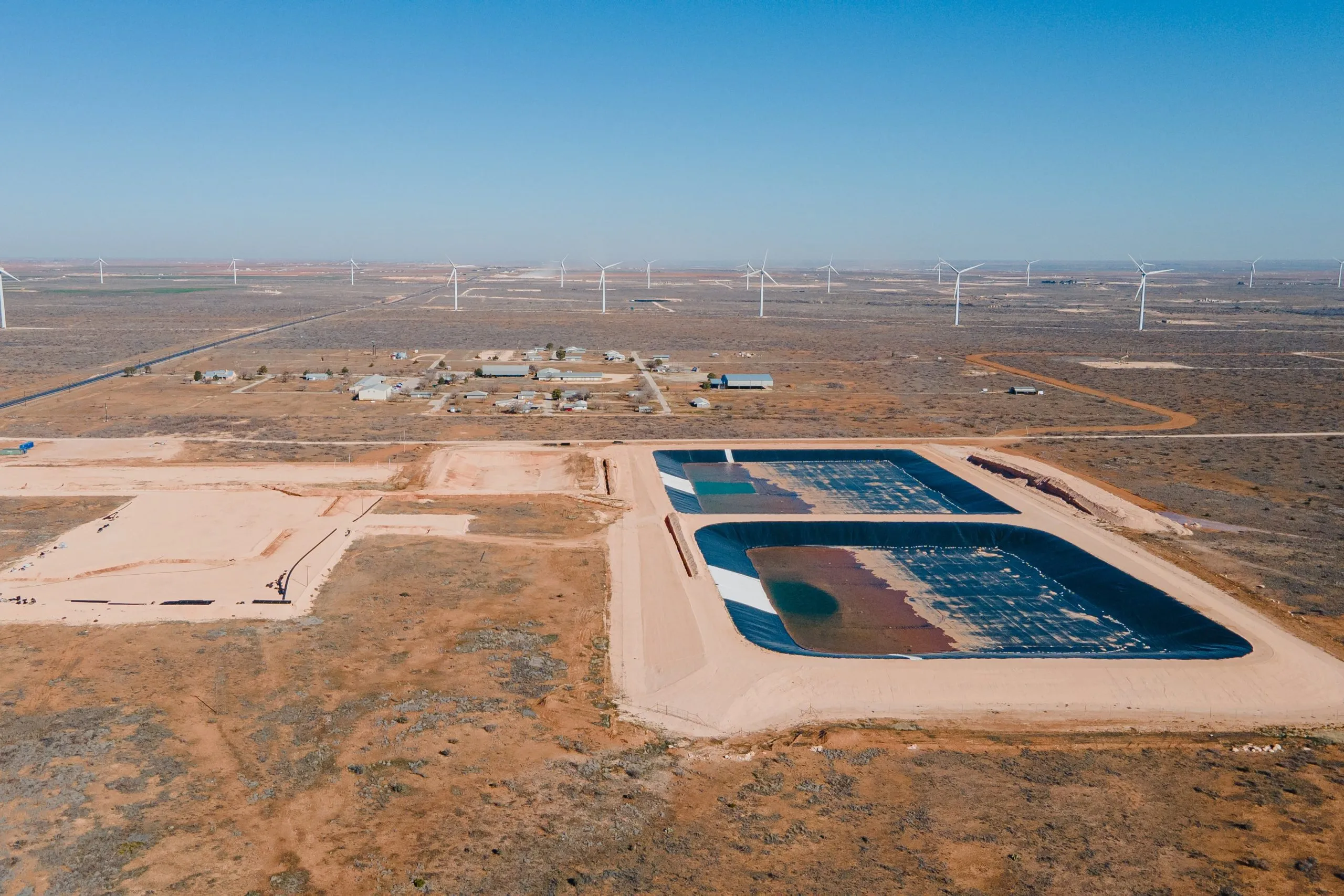

Era 1: Historical unlined earthen reserve pit in Permian Basin

But risks were massive: groundwater contamination, NORM accumulation, stormwater overflows, sludge buildup. TRRC Rule 8 updates in 2001 and 2007 ended unlined pits.

Era 2: Lined Pits + Basic Mechanical Separation (2008–2014)

Horizontal drilling boomed, pushing flowback volumes to 40,000–80,000 barrels per well in the first 30 days.

Operators switched to HDPE-lined pits, three-phase separators, skim tanks, and occasional portable centrifuges.

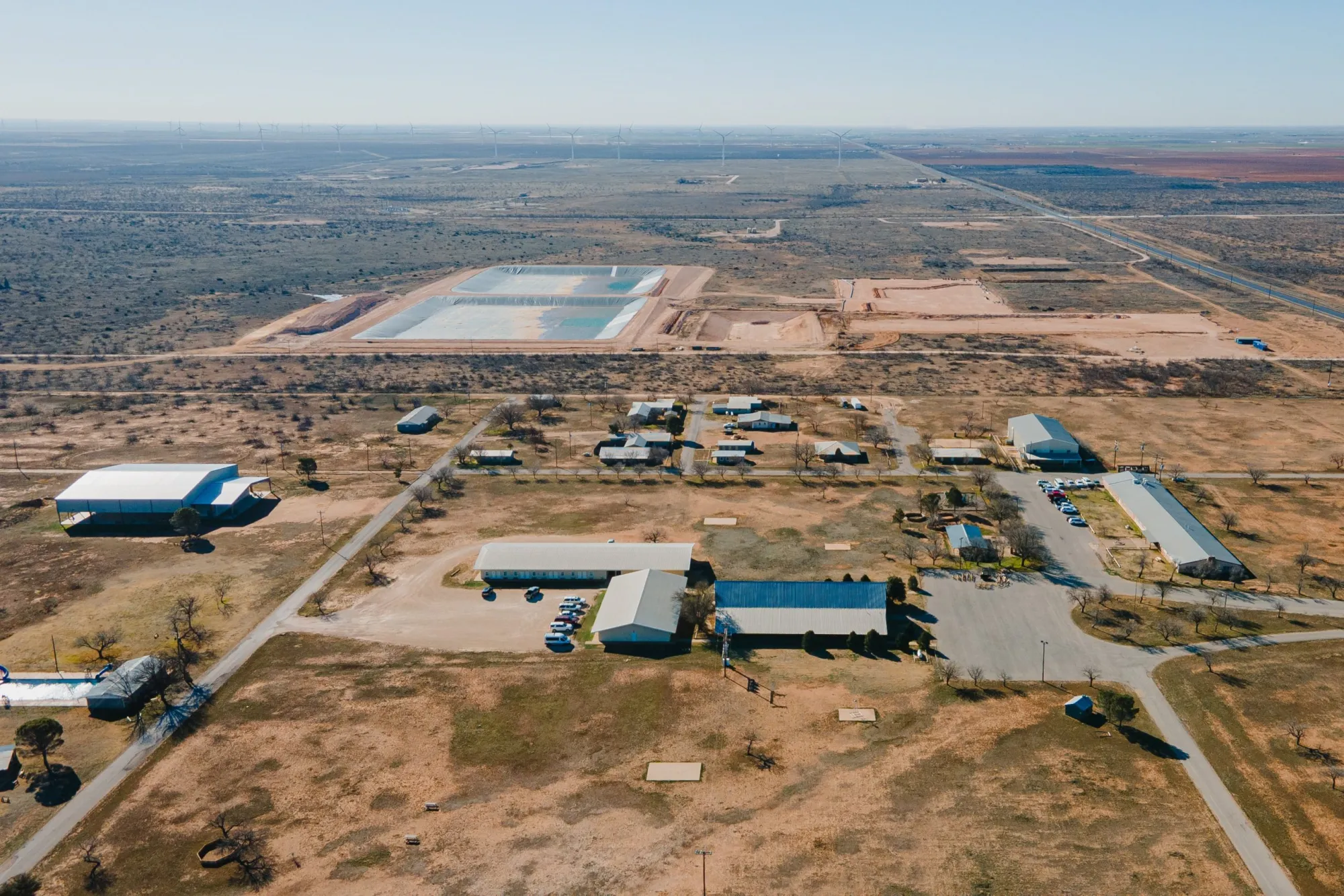

Era 2: Lined reserve pit in Permian Basin

Disposal was cheap ($0.15–$0.30/bbl), so focus was “get it out of the way” — not optimization.

Era 3: Centralized Facilities + Early Chemical Treatment (2015–2020)

2014 oil crash + seismicity issues forced change. Midstream built pipelines and centralized facilities.

Chemical programs emerged: inorganic coagulants, oxidation, scale inhibitors, and basic anionic PAM.

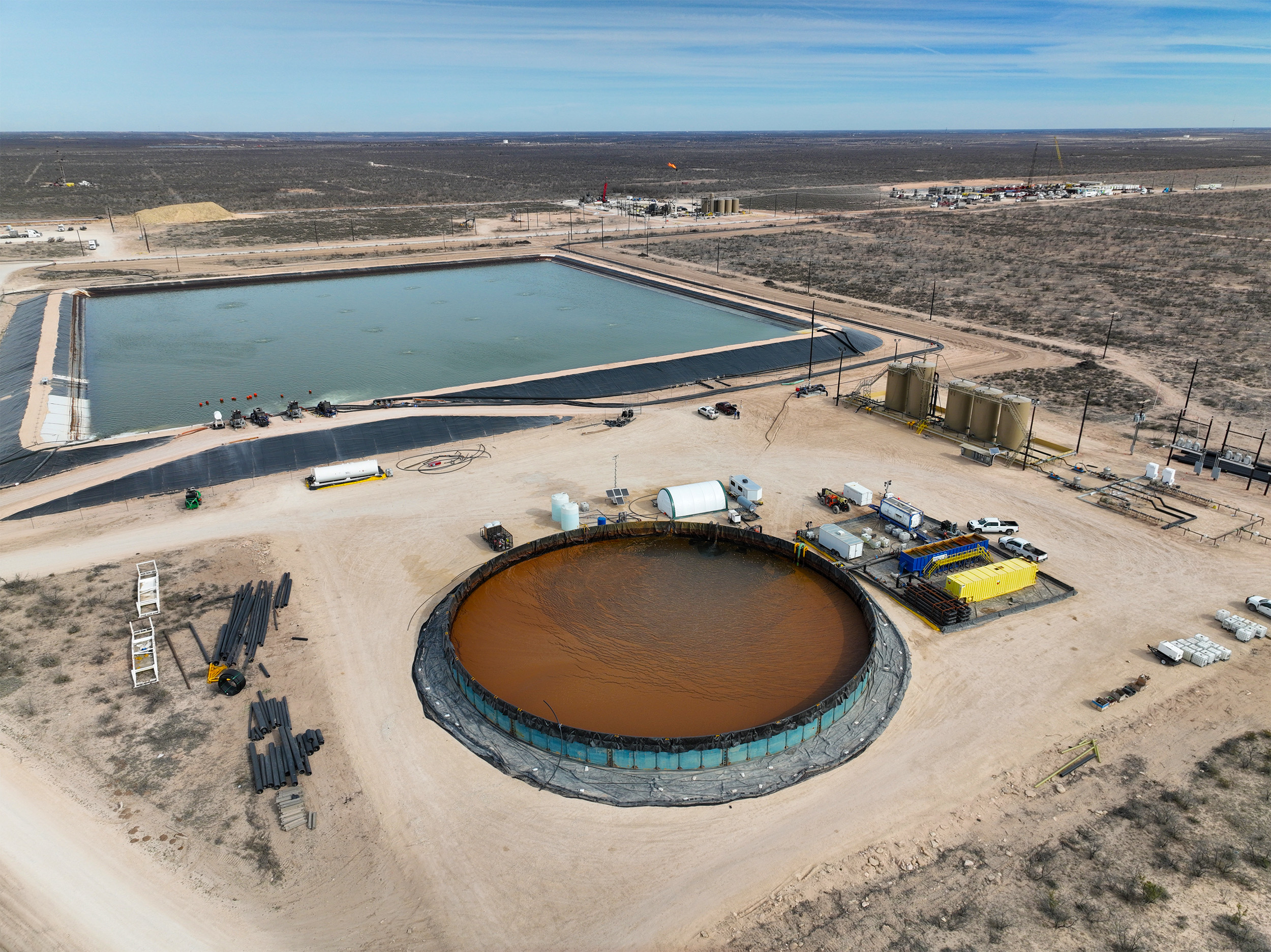

Era 3: Aerial view of centralized produced water treatment facility

Performance improved, but commodity anionic PAM struggled in high-TDS water. TSS removal often 60–75% — not optimal.

Legacy vs. Current Approach: Direct Comparison (2026)

Parameter Open Pit Era (Pre-2008) Lined Pit + Mechanical (2008–2014) Centralized + Basic Chemistry (2015–2020) Optimized Polymer (2021–2026)
TSS Removal Efficiency 25–45% 45–60% 60–75% 90–98%
Sludge Dry Solids Content < 2% 2–4% 4–8% 12–22%
Treatment Cost ($/bbl) $0.15–0.35 $0.25–0.55 $0.45–0.85 $0.55–$0.95 (reuse offset)
Reuse-Ready Water No No Rarely 70–85%
Sludge Volume (per 100k BPD) Unmanaged 450–700 wet tons 280–450 wet tons 80–150 wet tons
Regulatory Compliance Non-compliant Partial Partial Full TRRC + EPA

Sludge reduction alone saves mid-size facilities $8M+ per year.

CPAM in 2026: Why Polymer Selection Is a Core Engineering Decision

Top operators now treat cationic polyacrylamide (CPAM) as engineering priority — not commodity.

Flowback fines carry negative charges. Anionic PAM needs extra coagulant and fails in high-TDS. CPAM’s positive charge neutralizes particles directly, building dense flocs fast.

Benefits:

  • Faster settling
  • Higher TSS removal at lower doses
  • Drier sludge
  • Lower overall costs

Jar testing with real samples yields 20–35% better performance. In polyacrylamide technology, proper CPAM selection is now competitive edge.

As volumes rise, operators who engineer flowback treatment win big.

In our next article we will dive deeper into sludge dewatering — the final critical step that turns these polymer systems into real cost savings and reuse success.
